Antioch Brackish Water Desal Project
From The Antioch Herald: City of Antioch breaks ground on historic, first desalination project in Delta
From the Contra Costa Herald: City of Antioch breaks ground on historic, first desalination project in Delta
Antioch’s Need for Desalination

The City of Antioch’s current water supply system serves over 112,000 people within a 28.8 square-mile service area. The main sources of water for the City include water pumped from the San Joaquin River under the City’s senior (pre-1914) water right, and purchases from the Contra Costa Water District (CCWD). The quantity and quality of the water at the City’s San Joaquin River intake is impacted largely by factors outside of the City’s control (e.g. other delta projects, climate change, sea level rise, and state water project operations). The amount used from each source depends on the time of year and the type of year (dry or wet). The City uses river water as much as possible, because it is less expensive than water purchased from CCWD. However, over the years as the salinity of the river water has increased steadily, the City has been forced to purchase more water from CCWD as shown on the graph below.
Calendar of Events
Upcoming Events
There are no upcoming events at this time.
Past Events
Groundbreaking
February 19, 2021 @ 10:30 amCouncil Meeting
December 18, 2020Council Meeting: Final Staff Report
October 27, 2020Council Meeting: Project Update, Presentation, Resolution
August 11, 2020Council Meeting
July 28, 2020Council Meeting (temporarily Delayed)
October 22, 2019
The City of Antioch’s Brackish Water Desalination Project is being implemented to provide the City’s water supply reliability, provide operational flexibility while reducing costs, especially during droughts and with future proposed changes in Delta water management. The Project will allow the City to use water from the river year-round, even when the salinity is above levels normally treated at the existing conventional Water Treatment Plant.
The Brackish Water Desalination Project is an important component to the City of Antioch’s long-term strategy to improve its water supply reliability by diversifying its supply sources. This strategy will allow the City to reduce its dependence on higher-cost CCWD purchased water that is vulnerable to droughts, natural disasters and regulatory restrictions. Depending on drought conditions, the plant will account for over half of all water generated in the City during certain months of the year and about 30% on an annual basis.
The main Project objectives include:
- Improve water supply reliability and water quality for customers.
- Develop a reliable, drought-resistant water supply to reduce the City’s dependency on purchased water supplies by preserving the value and maximizing the use of the City’s pre-1914 water rights.
- Minimize project capital costs and reduce construction impacts by maximizing the use of existing infrastructure.
- Implement a cost-effective project that provides for operational flexibility and allows the City to quickly respond to changes in source water quality, emergencies, and changes associated with climate and California Bay-Delta conditions.
What is Brackish Water Desalination?
Desalination is the process of removing minerals and salts from water to produce a purified water. This is achieved by pushing water at a high pressure through reverse osmosis (RO) membranes (semipermeable membrane) to remove salt and other minerals.
The source water for desalination can come from a variety of sources including seawater, agricultural run-off, salty groundwater, or other brackish water sources. Brackish water refers to water that has higher concentrations of chlorides (salinity) and total dissolved solids (TDS) than freshwater, but is not as salty as ocean water. Ocean water has approximately 35,000 mg/L of TDS, while brackish water can range from 1,000 to 10,000 mg/L of TDS.
At certain times of year, the waters near the City of Antioch are considered brackish when San Joaquin River flows decrease and the salty Bay waters reach further upstream. Because brackish water has lower concentrations of TDS and nitrates, less energy is needed to push the water through the RO membranes. Brackish water desalination can produce potable water supply at less than half the energy usage of seawater desalination.
Before the finished water is ready to be pumped into the water system and distributed to customers, minerals are reintroduced into the water to make it compatible with other water supplies.
Project Description
The Antioch Brackish Water Desalination Project, which utilizes existing infrastructure to the extent possible, includes the construction of new desalination facilities and associated infrastructure, in order to improve the City’s water supply reliability and operational flexibility. Once constructed the desalination facility, located at the existing water treatment plant, will provide for 6 million gallons per day of capacity (producing up to 5,500 acre feet per year (ac-ft/yr), helping the City reduce its purchases of more expensive CCWD water.
Project Components
The Antioch Brackish Water Desalination Project consists of the following components:
- New river intake pump station to replace the existing San Joaquin River intake pump station. The pump station will consist of three 8 mgd pumps (16 mgd firm capacity) each with a fish screen that meets the protective criteria of the California Department of Fish and Wildlife and National Marine Fisheries Service.
- New 3,000 foot pipeline connecting the City’s existing raw water pipeline to the City’s Water Treatment Plant to allow a direct connection and maximize the use of existing infrastructure
- New 6 mgd desalination facility (reverse osmosis, post-treatment systems, chemical feed and storage facilities, brine conveyance facilities, and other associated non-process facilities).
- Approximately 4.3 miles of a new brine disposal pipeline to convey discharge brine the Delta Diablo Wastewater Treatment Plant for disposal into the San Joaquin River through an existing outfall. Discharge of brine water into the San Joaquin River will result in minor local increases in salinities that are within the tolerance range of native species.
Optimizing Use of Existing Infrastructure
The Project’s design optimizes the use of existing infrastructure to reduce overall construction related impacts to the community as well as overall project costs. Existing facilities that are utilized in this project include the:
- Existing raw water pipeline, from the San Joaquin River intake to the WTP, will be used to convey river water to the City’s water treatment plant.
- Existing Water Treatment Plant processes will provide for the pretreatment of the raw water prior being routed to the new advanced treatment facility (reverse osmosis).
- Existing Wastewater Treatment Plant effluent waters will be blended with the R.O. brine to reduce its salinity in order to meet river discharge requirements.
- Existing Wastewater Treatment Plant Effluent Pipeline and Delta Diablo Sanitation District Outfall will be used to convey the mixed effluent and brine water to the San Joaquin River for discharge.
Customers, Businesses and Visitors
Construction will have minimal to no impact on vehicle traffic. We welcome the opportunity to address any questions or concerns and encourage interested parties to contact us via the link below with any questions, comments or concerns.
Water treated at the City of Antioch’s Brackish Water Desalination Facility will enter the City’s drinking water distribution system and benefit all residents, businesses and visitors who receive water from the City of Antioch, approximately 112,000 people. Construction will have minimal to no impact on vehicle traffic. We welcome the opportunity to address any questions or concerns and encourage interested parties to contact us via the link below with any questions, comments or concerns.
Location
The Project facilities will predominately be located in the City of Antioch, California. The desalination facility will be located within the fence line of the City’s existing water treatment plant at 401 Putnam Street, Antioch and the pipeline routes will follow road right-of-ways. The brine will be conveyed to the Delta Diablo Wastewater Treatment Plant in Pittsburg, CA and then discharged to the San Joaquin River west of the Dow Wetlands Preserve using the existing WWTP outfall.
Project Cost and Financing
The total capital cost of the Project is approximately $110 million which will be financed through a variety of sources. Potential sources include the Department of Water Resources Proposition 1 Desalination Grant, a State Revolving Fund loan, and the City of Antioch’s Water Enterprise Fund.

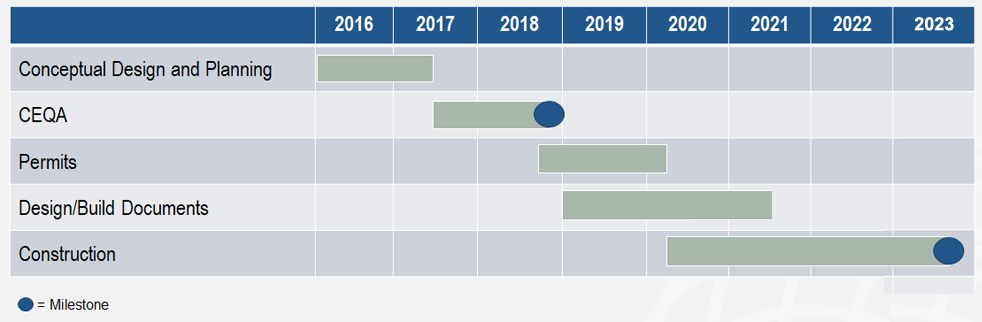

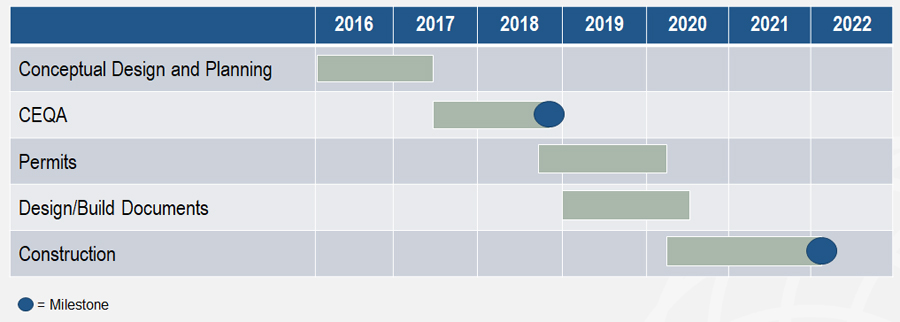

Project Timeline
- Delta Diablo – Reverse Osmosis Agreement
- Delta Diablo – Reverse Osmosis Agreement – Amendment No.1
- Resolution #2018/136 Approving Final Environmental Impact Report
- Notice of Determination
- Notice of Preparation
- Final Environmental Impact Report (FEIR)
- Notice of Availability
- Revised Notice of Availability
- Draft Environmental Impact Report (DEIR)
- Draft Environmental Impact Report (DEIR) Appendix
- Staff Report on Environmental Process for Project
December 18, 2020
October 27, 2020
August 11, 2020
July 28, 2020
October 22, 2019
March 6, 2019
October 23, 2018
October 9, 2018
August 14, 2018
- 2018 08 14 Minutes
- 2018 08 14 Resolution USBR WIIN Grant
- 2018 08 14 Staff Report USBR WIIN $15,750,000 Grant App
August 1, 2018
- 2018 08 01 Minutes from PC
- 2018 08 01 Power Point DEIR Comments for Planning Commission.pptx
- 2018 08 01 Staff Report to PC for Draft EIR
July 24, 2018
- 2018 07 24 Minutes
- 2018 07 24 Resolution (Reimb) SWRCB SRF $55 Mil Loan
- 2018 07 24 Staff Report Reimb Reso $55 Mil SWRCB Loan App
June 26, 2018
- 2018 06 26 Minutes
- 2018 06 26 Resolution Auth App for SRF Loan
- 2018 06 26 Staff Report $55 Mil Loan App to SWRCB
December 12, 2017
September 5, 2017
August 8, 2017
July 25, 2017
- 2017 07 25 Minutes
- 2017 07 25 Resolution Auth $10 Mil Grant App with DWR
- 2017 07 25 Staff Report $10 Mil DWR Grant App & Reso
April 12, 2016
- 2016 04 12 Minutes
- 2016 04 12 Resolution Pledge Revenues
- 2016 04 12 Staff Report Pledged Revenue Funds & Designate City Mgr & Reso
January 26, 2016
